We use cookies to ensure our site functions properly and to store limited information about your usage. You may give or withdraw consent at any time.To find out more, read our privacy policy and cookie policy.
Manage Cookies
A cookie is information stored on your computer by a website you visit. Cookies often store your settings for a website, such as your preferred language or location. This allows the site to present you with information customized to fit your needs. As per the GDPR law, companies need to get your explicit approval to collect your data. Some of these cookies are ‘strictly necessary’ to provide the basic functions of the website and can not be turned off, while others if present, have the option of being turned off. Learn more about our Privacy and Cookie policies. These can be managed also from our cookie policy page.
Strictly necessary cookies(always on):
Necessary for enabling core functionality. The website cannot function properly without these cookies. This cannot be turned off. e.g. Sign in, Language
Analytics cookies:
Analytical cookies help us to analyse user behaviour, mainly to see if the users are able to find and act on things that they are looking for. They allow us to recognise and count the number of visitors and to see how visitors move around our website when they are using it. Tools used: Google Analytics
No analytics cookies have been enabled on this site. There are no cookies to review.
The District of Ucluelet commissioned the 2023 Sanitary Sewer Master Plan, which identified significant capacity limitations affecting the Official Community Plan's (OCP) projected growth. After further review and analysis of the system, it was determined there were several bottlenecks that could halt development approvals until key projects were implemented

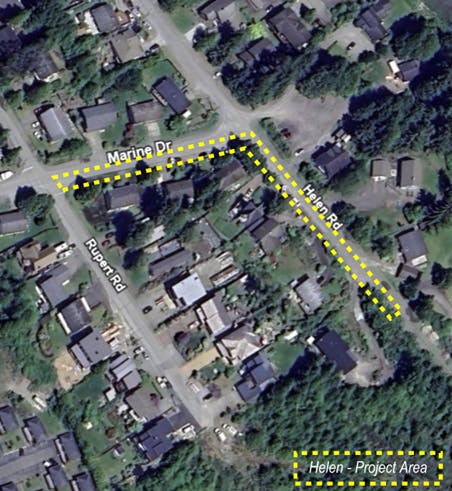

Helen Road Area
The Helen Road Area sanitary sewer project involves the replacement and upsizing of the existing gravity main along Marine Drive from Rupert Road to Helen Road and along Helen Road from Marine Drive to 1136 Helen Road. The alignment of the sewers run on the south side of Marine Drive and along the west side of Helen.

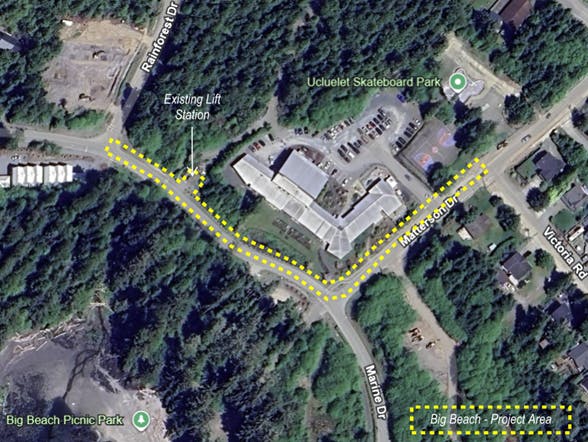

Big Beach
The existing lift station on Marine Drive will be upgraded with new pumps and controls. The project also involves replacement and upsizing of the gravity sewer main along Marine Drive from Rainforest Drive to the lift station, and replacement and upsizing of the force main on Marine Drive from the lift station to Matterson Drive, and on Matterson Drive from Marine Drive to Victoria Road. The alignment of the sewers run on the north side of Marine Drive and along the west side of Matterson Drive.
Anticipated Impacts
Working hours will be Monday to Friday from 7am to 6pm. As this project will involve trenching and deep excavations, anticipated impacts are likely to include temporary changes to traffic patterns and noise from heavy machinery.
Access to residences and businesses will be coordinated by the contractor. Temporary ramps or walkways may in place at times to maintain access.
The project will utilize a material staging area in the gravel parking lot at Seaplane Base Road as shown in the photos.
Schedule
The overall project completion is planned for November 2026. While the schedule is subject to change depending on various factors including weather, unknown conditions, material lead times, and contractor’s sequencing of work, the following are some approximate dates:
Hemlock Road Area
The underground pipe work and surface restoration is planned for February/March 2026 and the pump station civil and mechanical for May 2026. The electrical, commissioning, generator install, and final tie-ins are planned to follow and will depend on equipment lead times.
Helen Road Area
Construction of the Helen Road and Marine Drive sewer is planned to commence in March 2026 and be complete in March 2026.
Big Beach Area
The bulk of the construction on Marine Drive and Matterson is planned to start late January 2026 and be complete by March of 2026, while the pump station work on Marine Drive is planned to follow and will depend on equipment lead times.
Budget
Design
$ 332,925
Construction Costs
$ 3,783,121
Contingency
$ 574,250
Total Approved Budget
$ 4,690,299
May 2026 Update
Big Beach – Landscaping of Boulevard in Matterson is ongoing
Hemlock/Waterfront – Wet well and remaining deep underground piping excavation and installation has been taking place in May and is expected to be complete by the end of the month.
Helen – Pipe installation on Helen has been completed, and the contractor is now working on Marine Drive from Helen to Rupert.
All three sites (Big Beach, Hemlock, Helen) – paving of disturbed areas was complete at the end of April.
All three sites (Big Beach, Hemlock, Helen)- No work is planned for June aside from paving of disturbed areas at the end of May/beginning of June.
Background
The District of Ucluelet commissioned the 2023 Sanitary Sewer Master Plan, which identified significant capacity limitations affecting the Official Community Plan's (OCP) projected growth. After further review and analysis of the system, it was determined there were several bottlenecks that could halt development approvals until key projects were implemented
Helen Road Area
The Helen Road Area sanitary sewer project involves the replacement and upsizing of the existing gravity main along Marine Drive from Rupert Road to Helen Road and along Helen Road from Marine Drive to 1136 Helen Road. The alignment of the sewers run on the south side of Marine Drive and along the west side of Helen.
Big Beach
The existing lift station on Marine Drive will be upgraded with new pumps and controls. The project also involves replacement and upsizing of the gravity sewer main along Marine Drive from Rainforest Drive to the lift station, and replacement and upsizing of the force main on Marine Drive from the lift station to Matterson Drive, and on Matterson Drive from Marine Drive to Victoria Road. The alignment of the sewers run on the north side of Marine Drive and along the west side of Matterson Drive.
Anticipated Impacts
Working hours will be Monday to Friday from 7am to 6pm. As this project will involve trenching and deep excavations, anticipated impacts are likely to include temporary changes to traffic patterns and noise from heavy machinery.
Access to residences and businesses will be coordinated by the contractor. Temporary ramps or walkways may in place at times to maintain access.
The project will utilize a material staging area in the gravel parking lot at Seaplane Base Road as shown in the photos.
Schedule
The overall project completion is planned for November 2026. While the schedule is subject to change depending on various factors including weather, unknown conditions, material lead times, and contractor’s sequencing of work, the following are some approximate dates:
Hemlock Road Area
The underground pipe work and surface restoration is planned for February/March 2026 and the pump station civil and mechanical for May 2026. The electrical, commissioning, generator install, and final tie-ins are planned to follow and will depend on equipment lead times.
Helen Road Area
Construction of the Helen Road and Marine Drive sewer is planned to commence in March 2026 and be complete in March 2026.
Big Beach Area
The bulk of the construction on Marine Drive and Matterson is planned to start late January 2026 and be complete by March of 2026, while the pump station work on Marine Drive is planned to follow and will depend on equipment lead times.
Budget
Design
$ 332,925
Construction Costs
$ 3,783,121
Contingency
$ 574,250
Total Approved Budget
$ 4,690,299
May 2026 Update
Big Beach – Landscaping of Boulevard in Matterson is ongoing
Hemlock/Waterfront – Wet well and remaining deep underground piping excavation and installation has been taking place in May and is expected to be complete by the end of the month.
Helen – Pipe installation on Helen has been completed, and the contractor is now working on Marine Drive from Helen to Rupert.
All three sites (Big Beach, Hemlock, Helen) – paving of disturbed areas was complete at the end of April.
All three sites (Big Beach, Hemlock, Helen)- No work is planned for June aside from paving of disturbed areas at the end of May/beginning of June.
